2023

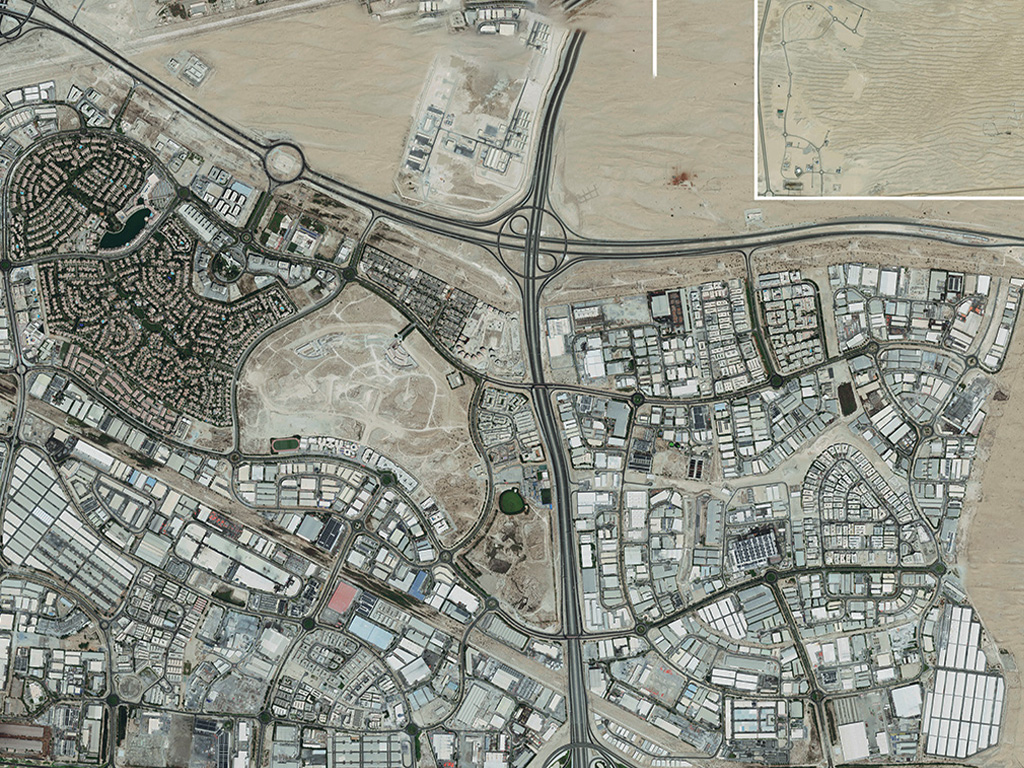

97% of DIP is leased out
2022

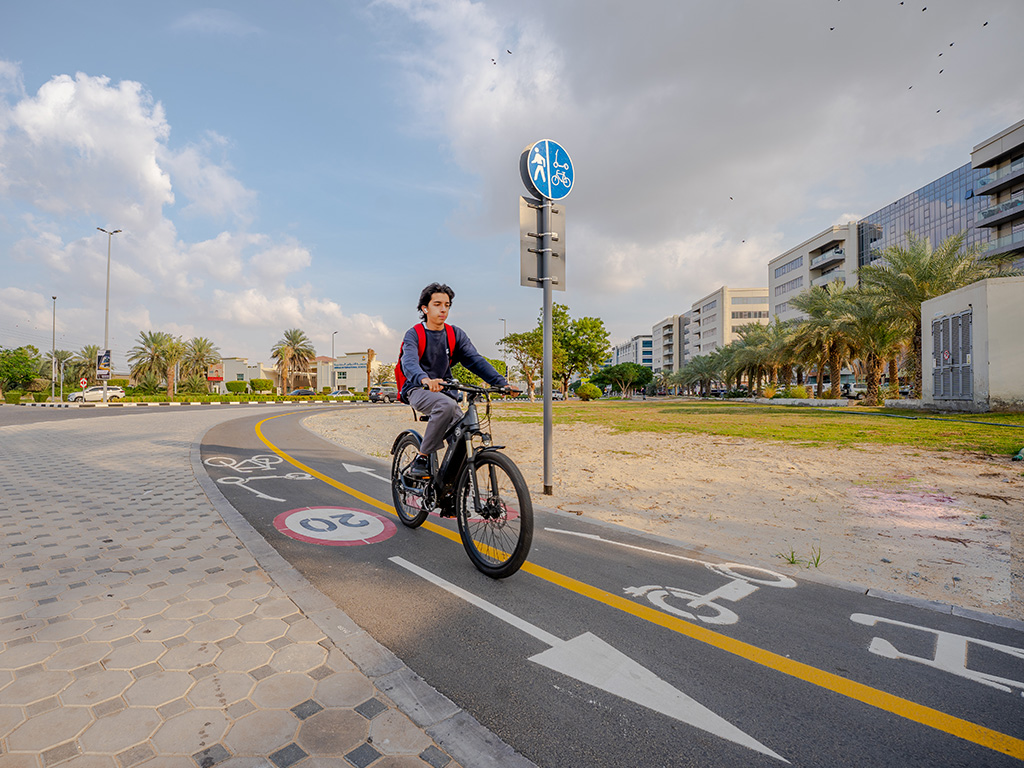

Phase 1 foot path and cycle track around the residential and commercial area completed
2021

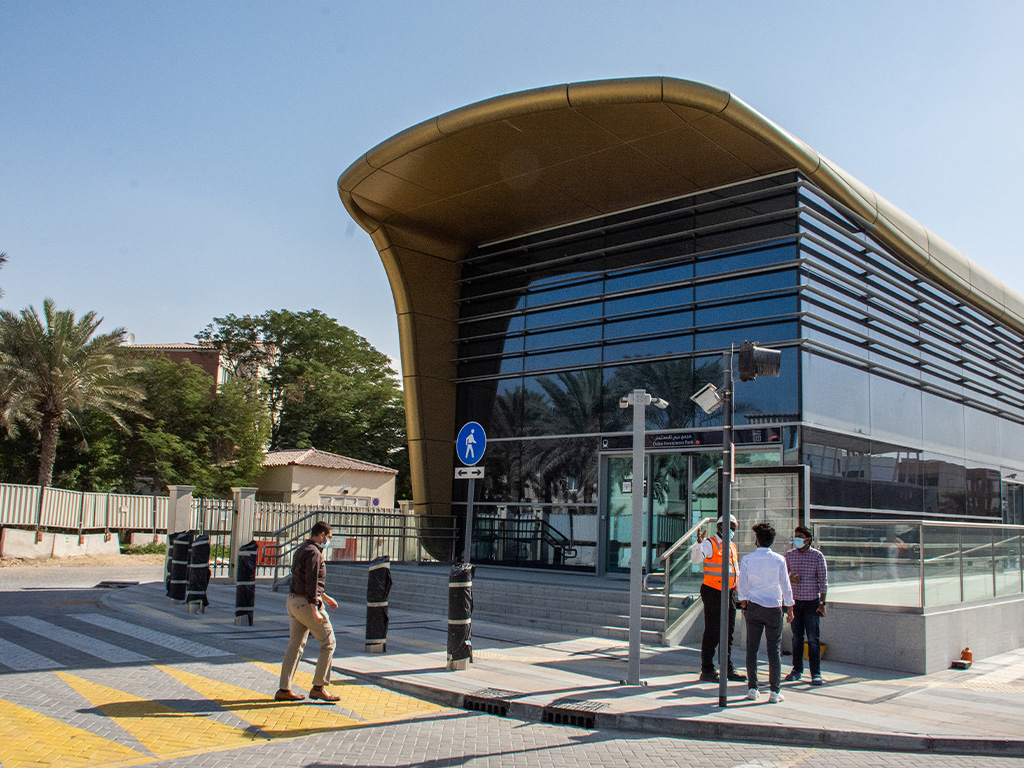

DIP Metro station operational NMC hospital extension started Infrastructure development across new subdivisions in DIP 1 & 2 completed
2020

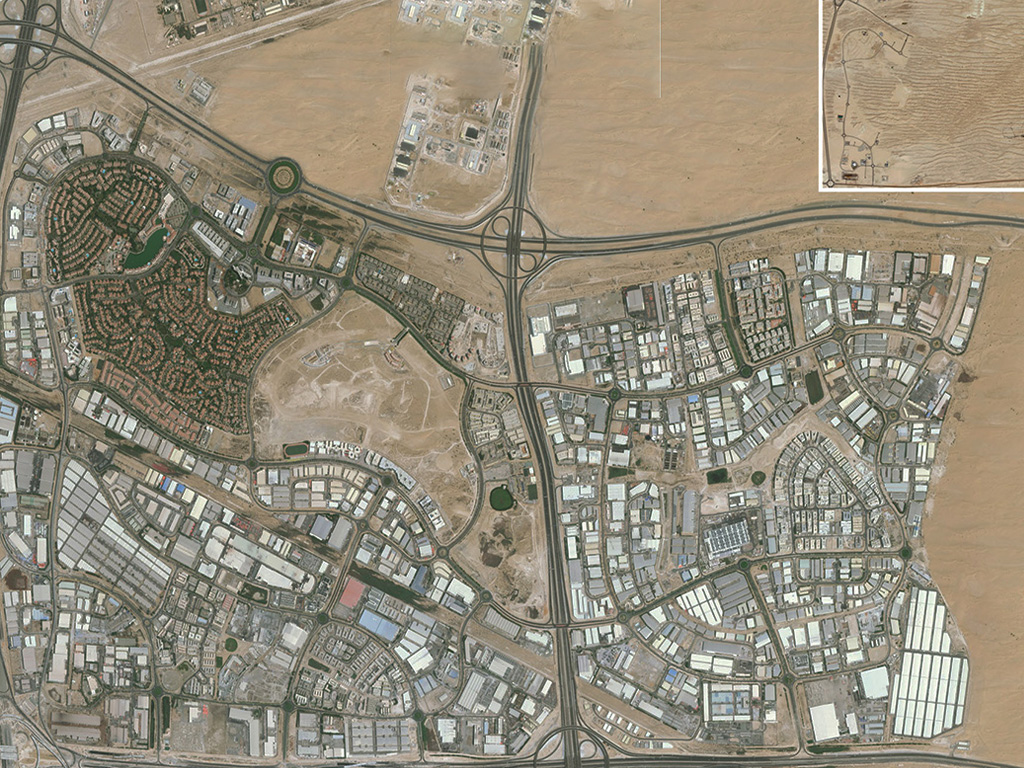

Value of investments in construction & building in excess of AED 42Bn over two decades
2019

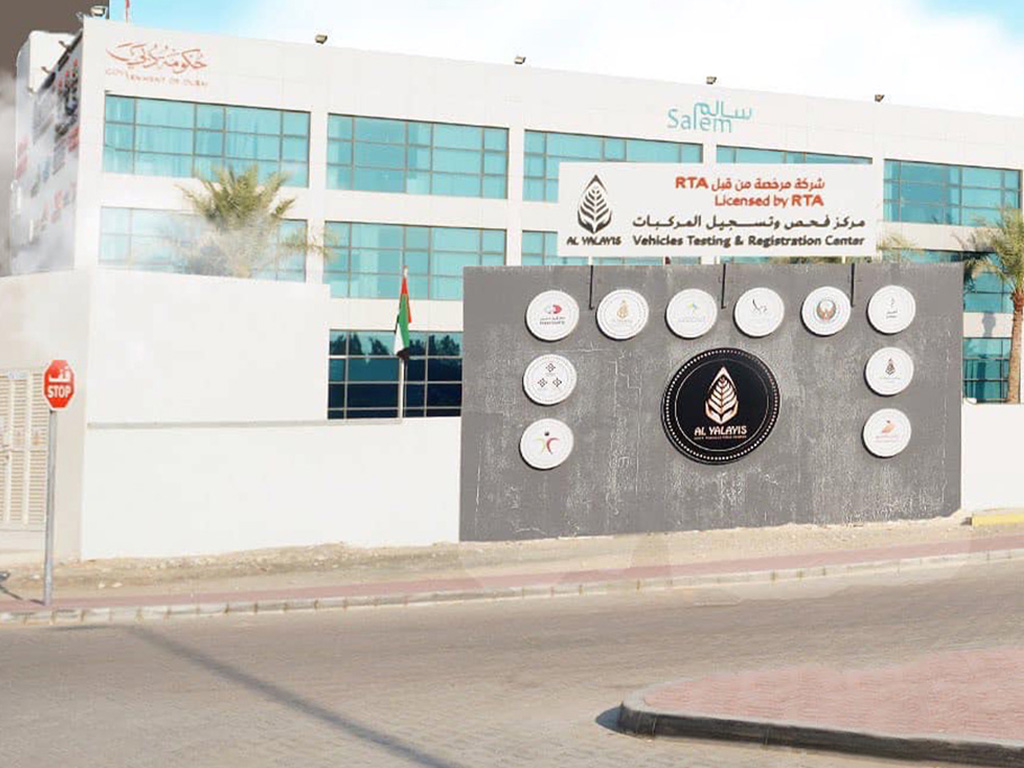

Infrastructure investment across DIP surged to AED 1.5Bn , since inception Al Yalayis govt transactions center inaugurated
2018

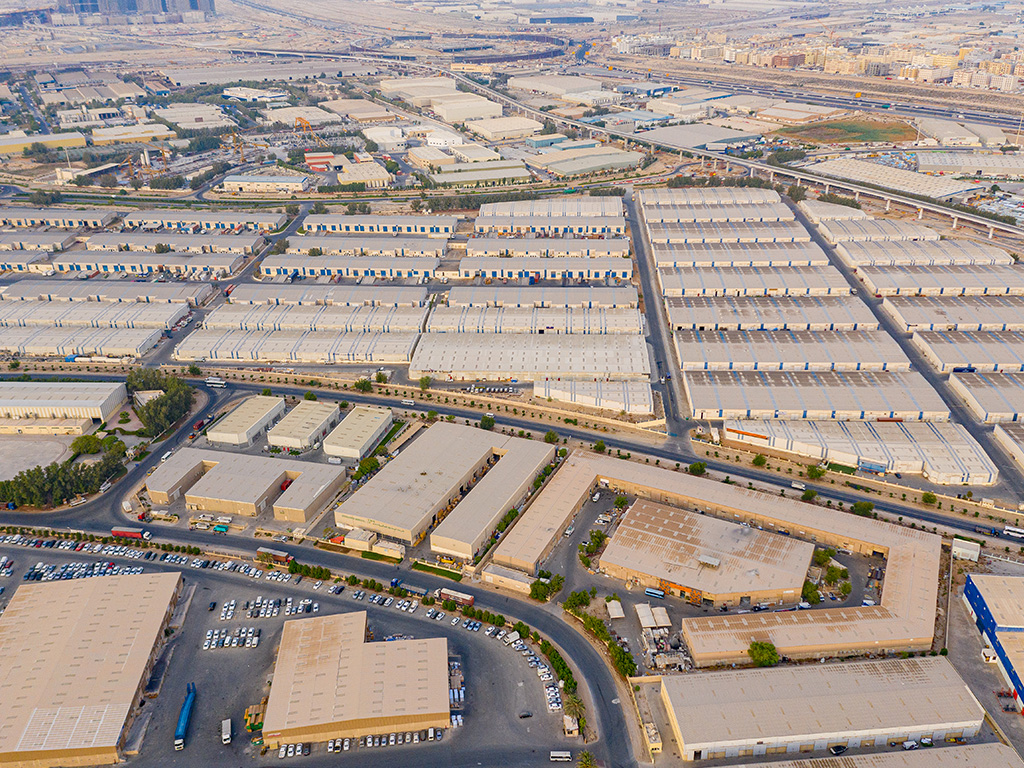

Over 95% of DIP land is leased and 98% of industrial zone is occupied
2016

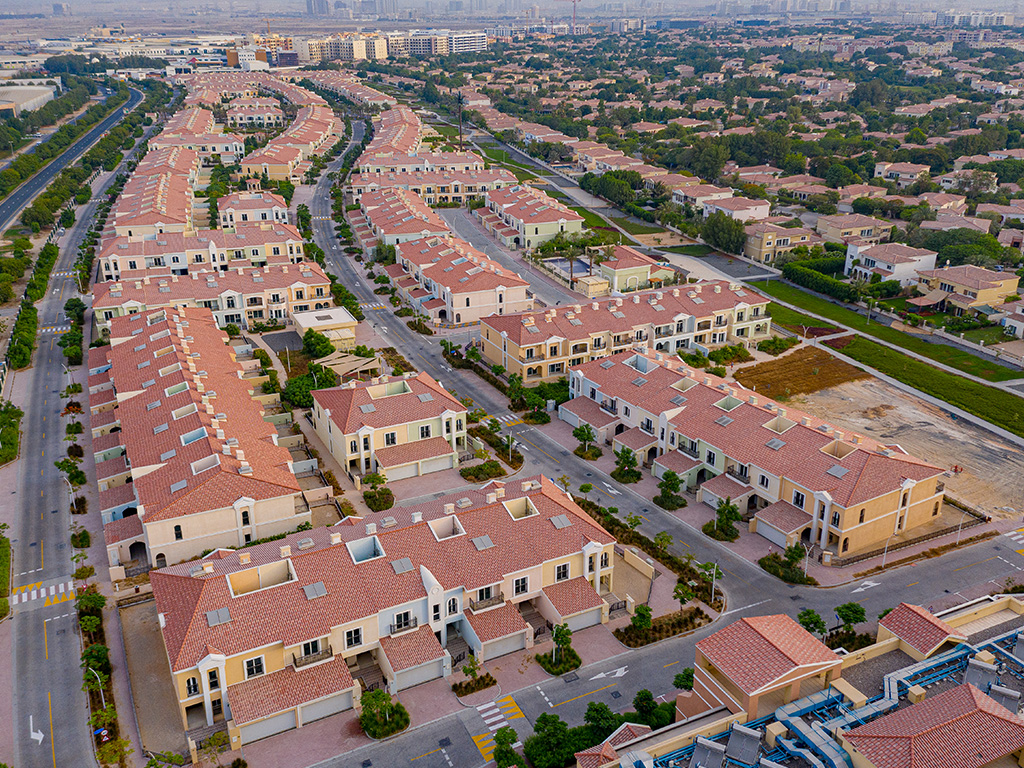

Construction of Green Community West phase 3 commenced Number of tenants crossed approx. 3,400
2015
New residential & hotel projects announced
2014

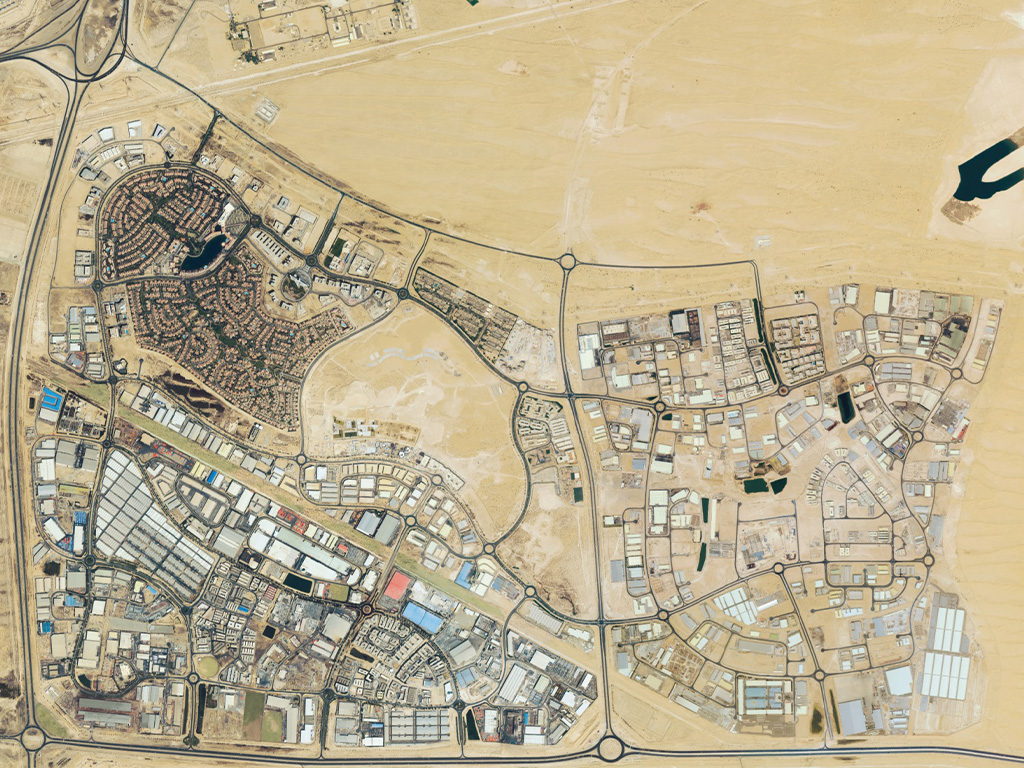

Phase 8 light industrial units fully constructed and handed over
2013

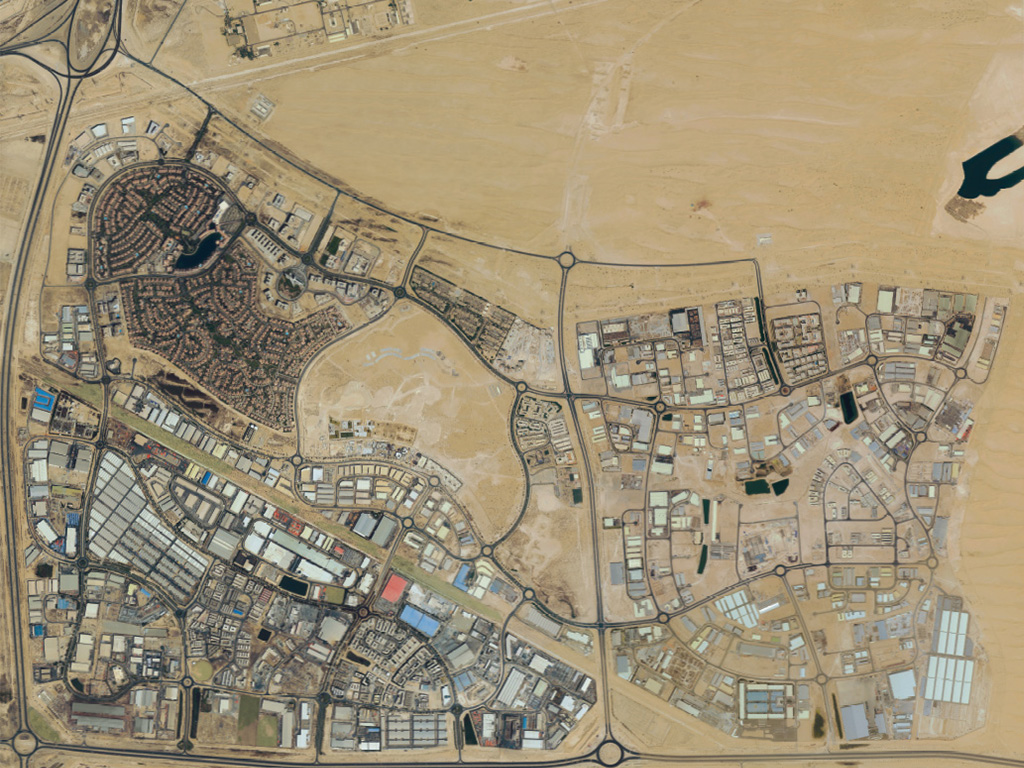

Number of tenants crossed approx. 2,500
2012
Fire station and Ambulance point construction completed
2011

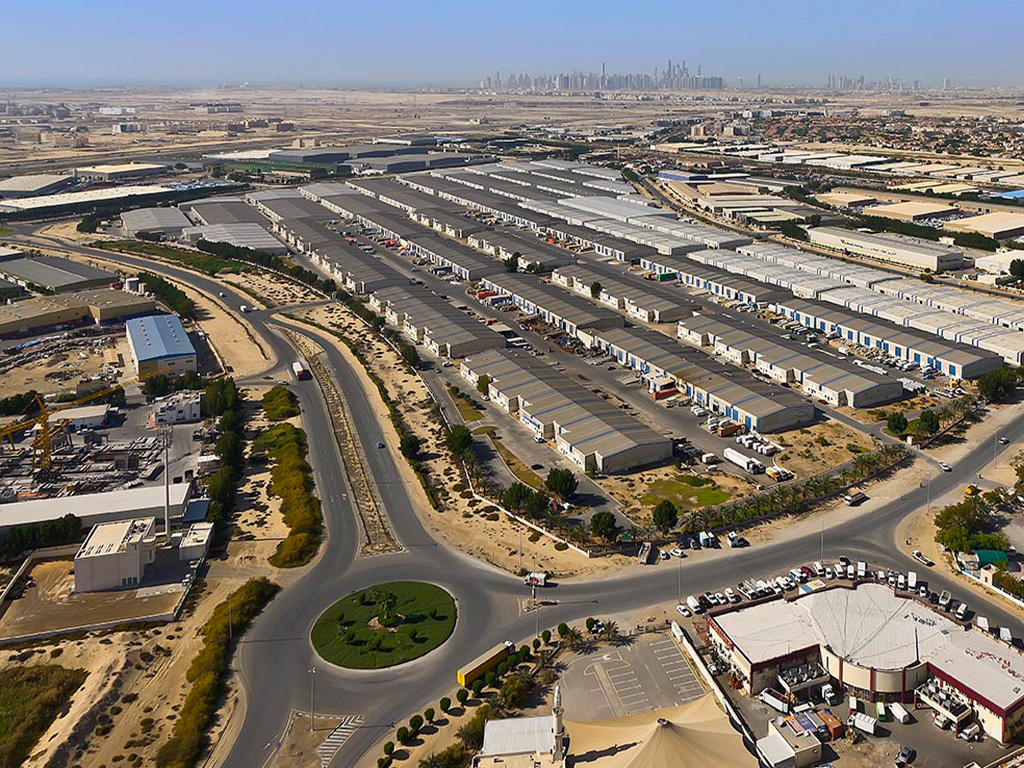

Phase 8 infrastructure along with light industrial units works commence
2010

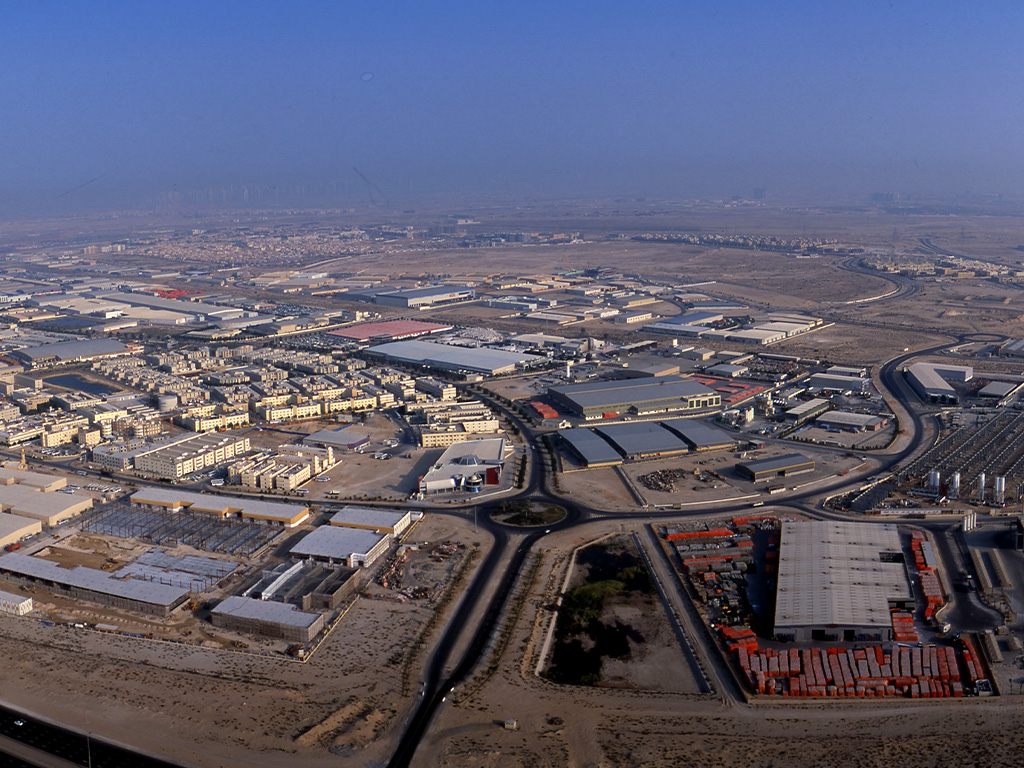

Number of tenants reaches approx. 800
2009

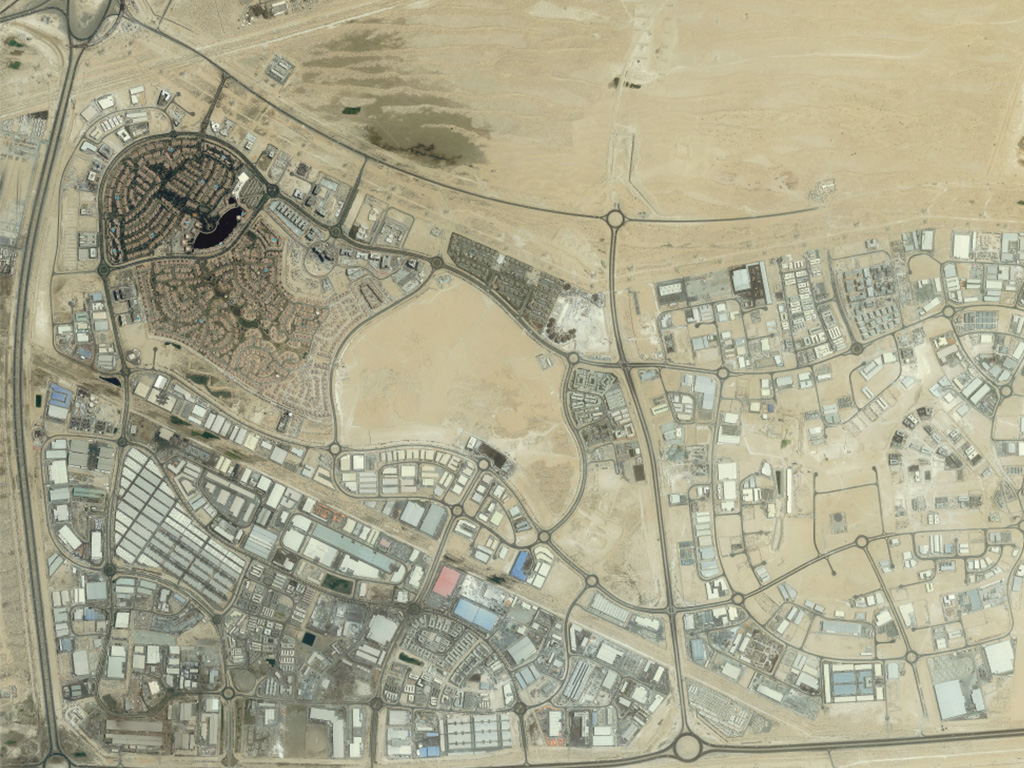

Phase 7 infrastructure works commence
2008

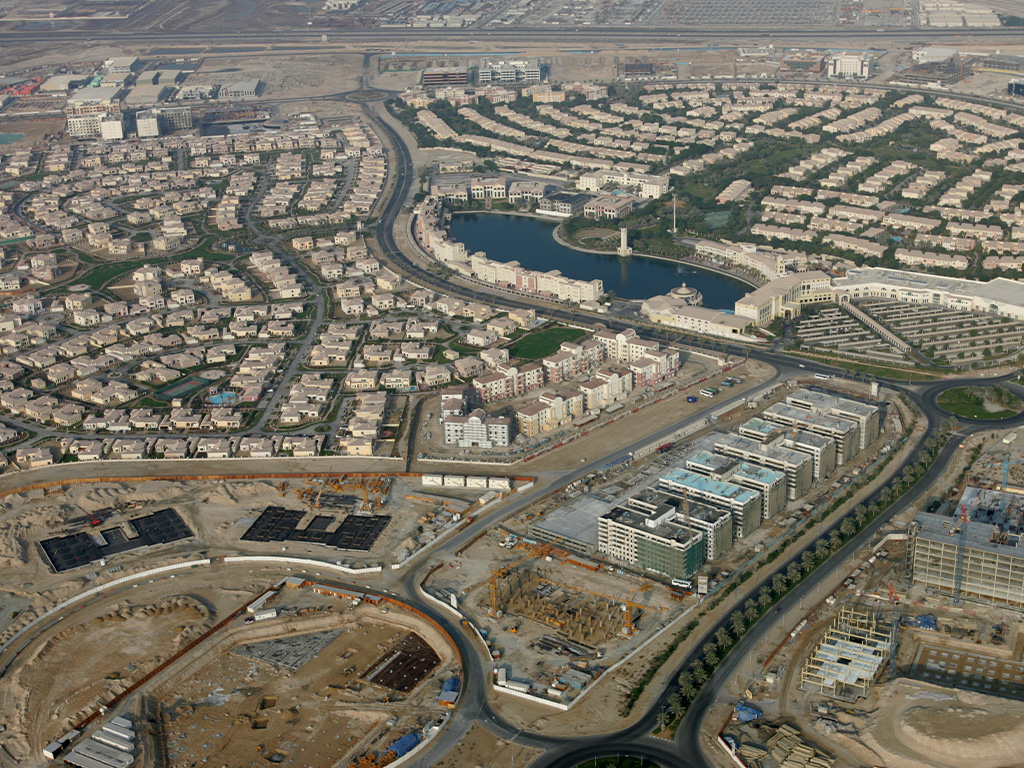

60% of DIP infrastructure completely developed
2007

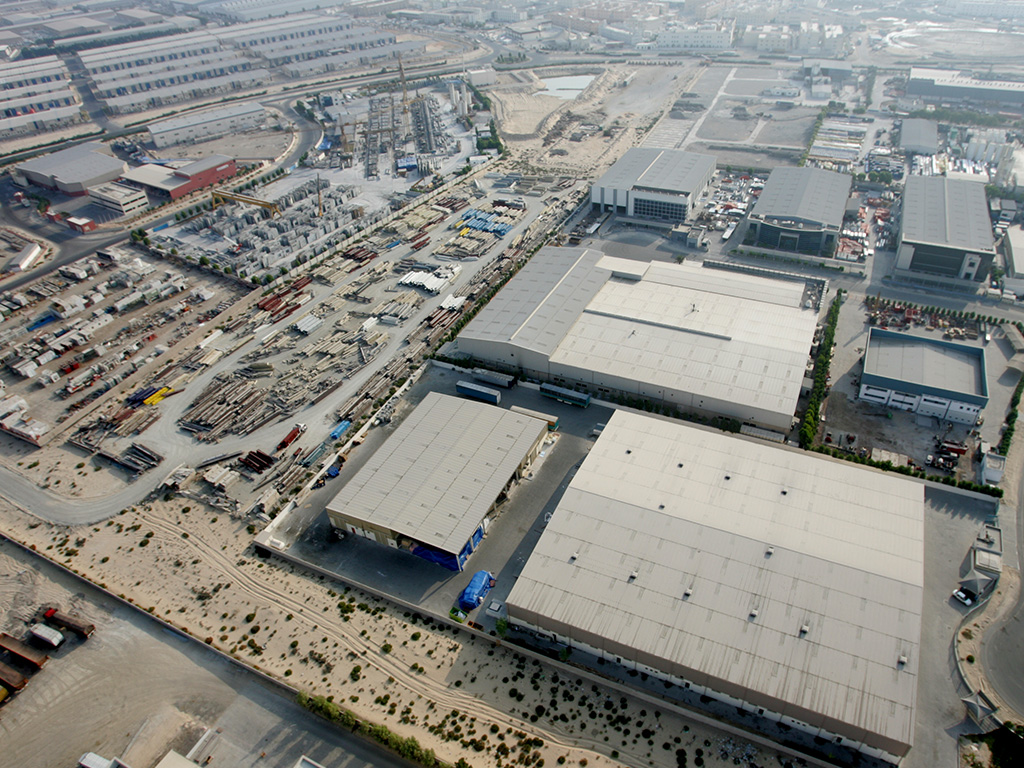

Number of tenants grows to approx. 450 Phase 6 Infrastructure works commence
2006

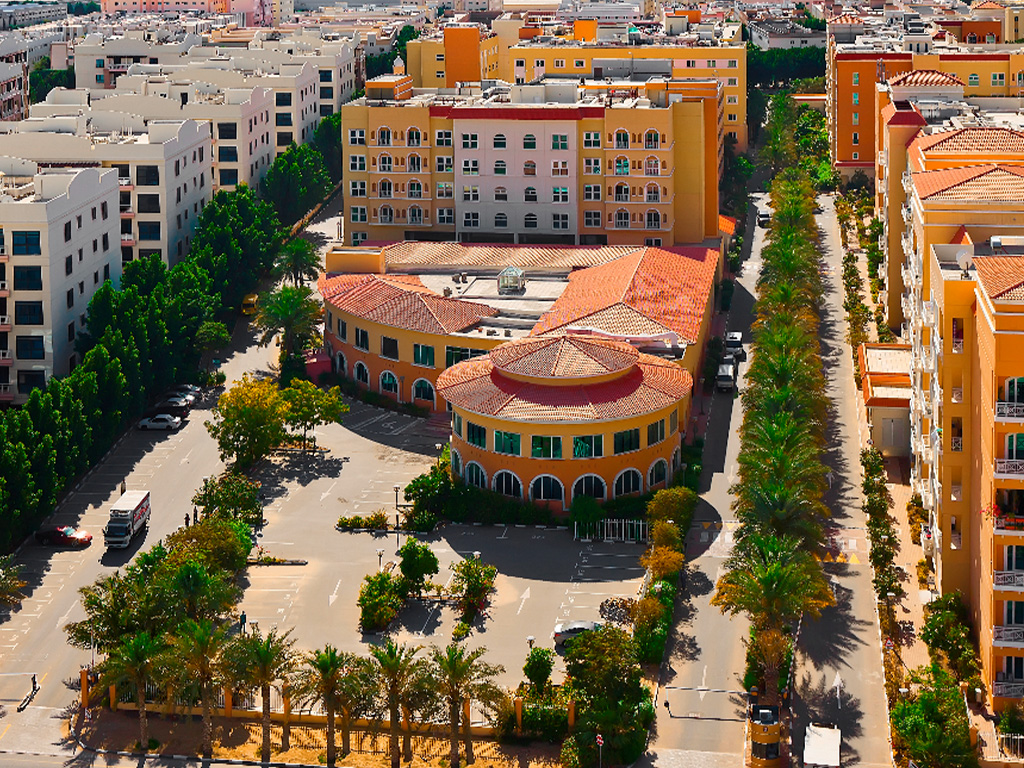

New Residential project - RITAJ - Launched
2005

Phase 4 & 5 infrastructure works commence
2004

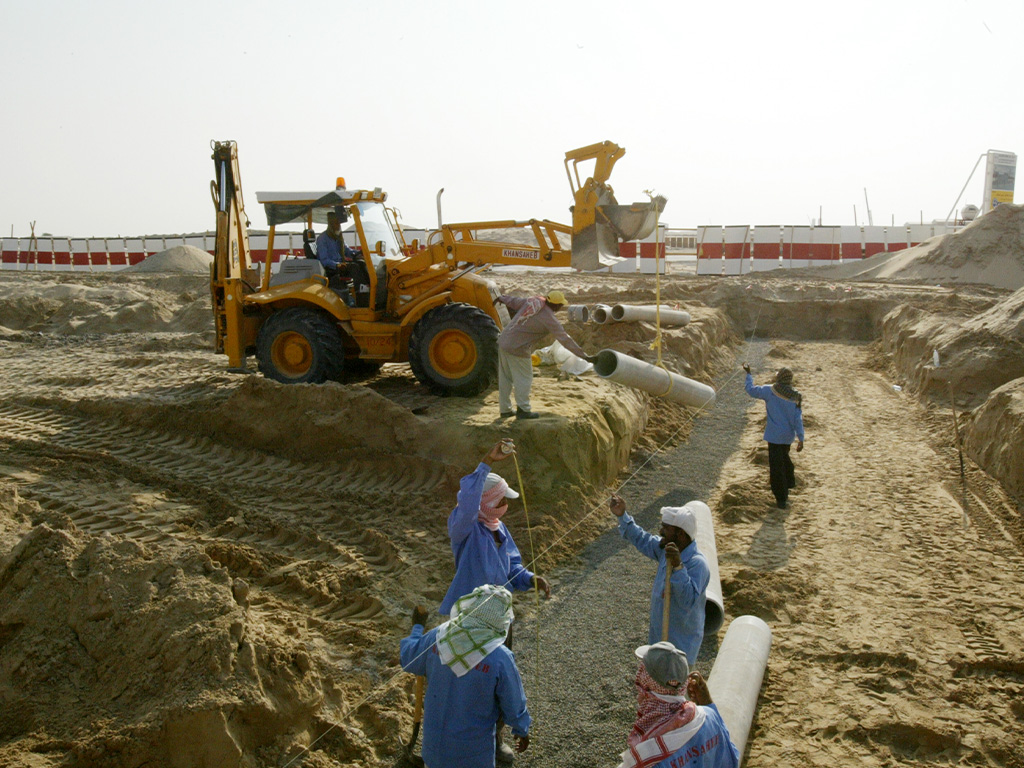

Phase 2 & 3 infrastructure works commence
2003
Inauguration of Phase 2 by HH Sheikh Hamdan Bin Rashid Al Maktoum
2002

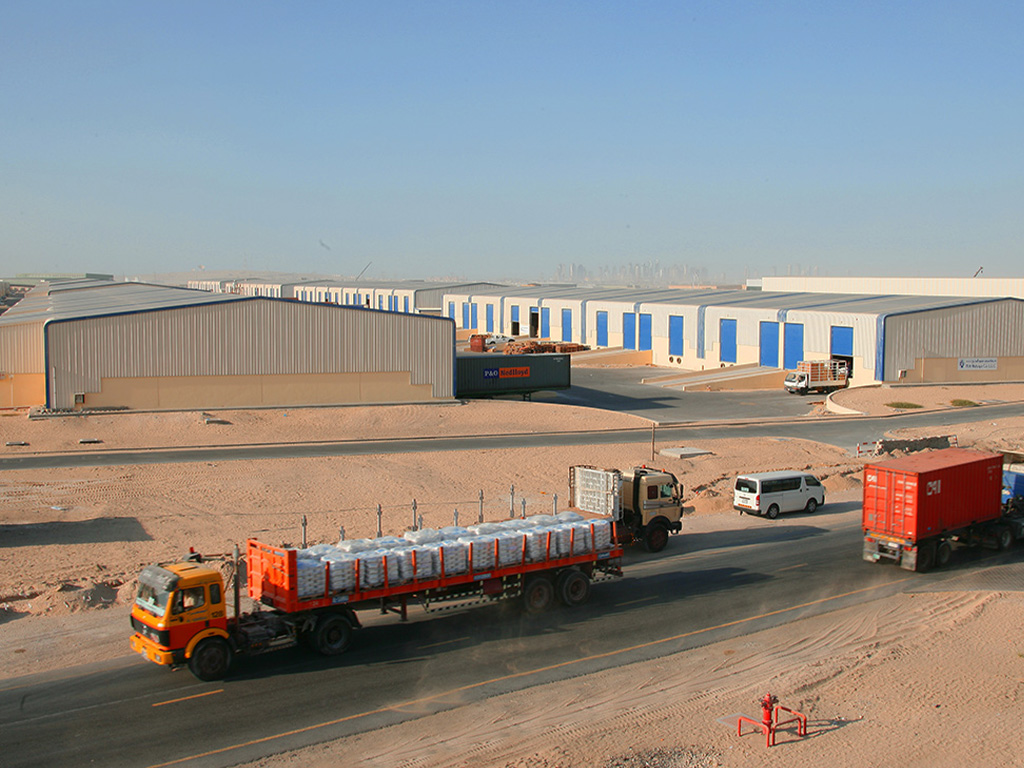

Phase 1 completely leased out
2001

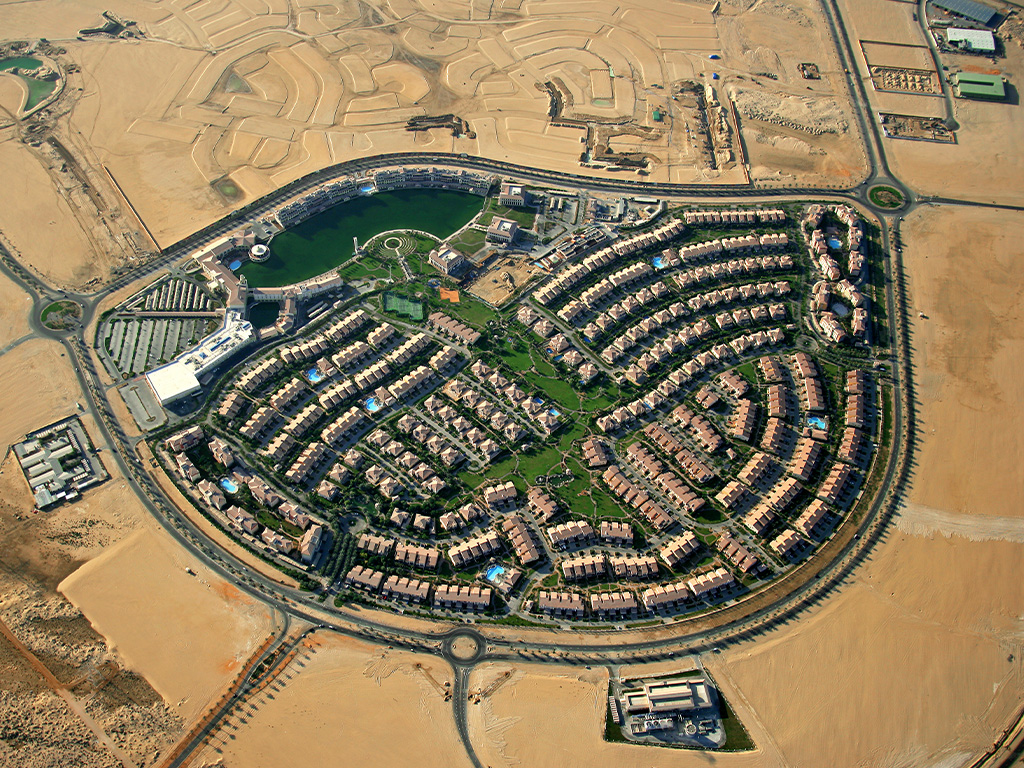

Major residential complex developed - Green Community DIP
2000

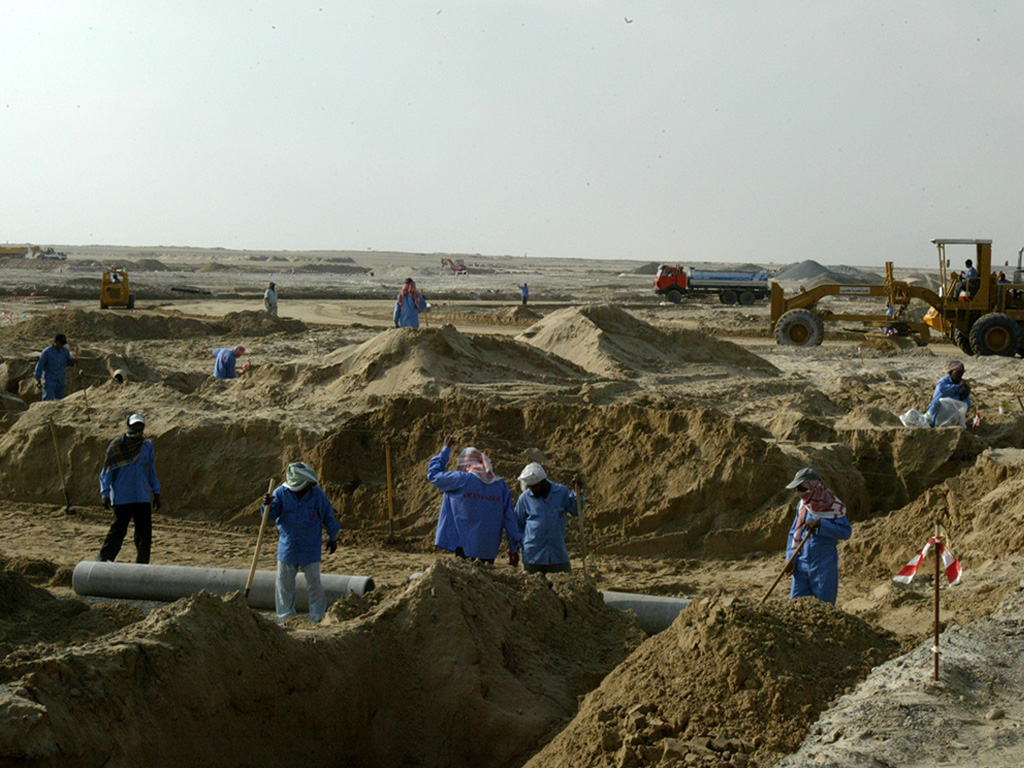

1st lease agreement signed & Phase 1 infrastructure commenced
1999
